2026 Información sobre el programa de emisiones y cero emisiones de carbono
Conozca el progreso que estamos logrando hacia nuestro objetivo 2030 de proporcionar energía libre de carbono a nuestros clientes.
Estos datos son sólo para fines informativos y no deben emplear con fines de planeación. Los datos están sujetos a cambios sin previo aviso.
Conozca nuestra 2030 Visión de Energía Limpia
2023 Reporte de Progreso del Plan de Carbono Cero
Generación trimestral y emisiones de las plantas de gas
| Energía generada a partir de plantas de gas que controlamos en 2026 |
|
1,205 |
--- |
--- |
--- |
Esperamos generar 6028 GWh de energía a partir de las plantas de gas que controlamos en 2026.

| Emisiones de la planta de gas para carga y ventas de mercado* |
| Pregunta1 2026 | Pregunta2 2026 | Pregunta3 2026 | Pregunta4 2026 | |
| Contrato de central térmica | 34k MT CO2e | --- MT CO2e | --- MT CO2e | --- MT CO2e |
| Central eléctrica de Cosumnes | 374k MT CO2e | --- MT CO2e | --- MT CO2e | --- MT CO2e |
| Cogens y plantas peaker | 59k MT CO2e | --- MT CO2e | --- MT CO2e | --- MT CO2e |
| Total | 467k MT CO2e | --- MT CO2e | --- MT CO2e | --- MT CO2e |
Nota: La central eléctrica de Cosumnes y las plantas de cogeneración y pico son recursos propiedad de SMUD.
SMUD's GHG emissions are estimated based on the amount of power generated at SMUD's gas plants and power purchased from the Calpine Sutter gas plant. Las emisiones de GEI previstas y reales de nuestra generación con combustibles fósiles reflejan las emisiones totales para atender las necesidades energéticas de los clientes de SMUD y las ventas en el mercado para apoyar a California y otrosestados vecinos. Las emisiones de GEI se estiman empleando los factores de emisión más recientes que se verificaron de acuerdo con el Reglamento de Reportes Obligatorios (MRR) de la Junta de Recursos del Aire de California (CARB).
Ver nuestra etiqueta de contenido de energía
Instalaciones solares y de almacenamiento
| Total de instalaciones solares* |

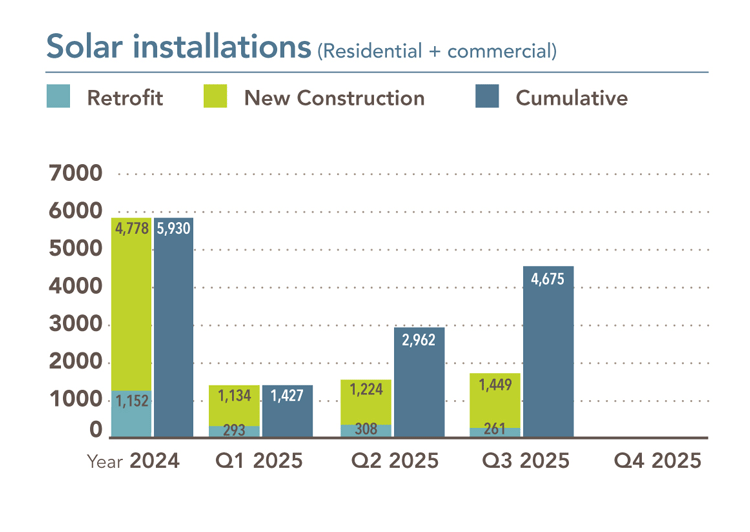

A lo largo de 58,000 clientes instalaron energía solar en los tejados, con un total de más de 387 MW de energía en el territorio de SMUD.
*Estos son sistemas completados/instalados. SMUD inspeccionó el sitio y dio la aprobación para que el sistema funcione.
| Instalaciones totales de almacenamiento de baterías |

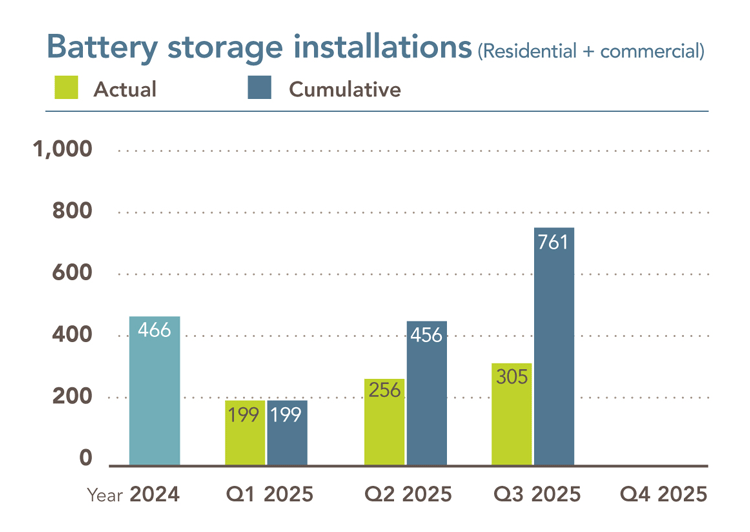

A lo largo de 2000 clientes instalaron almacenamiento en baterías, por un total de más de 13 MW de almacenamiento en el territorio de SMUD.
Estado del programa y del proyecto con cero emisiones de carbono
Lograremos nuestro objetivo 2030 a través del éxito de diferentes proyectos, programas y actividades. Los proyectos a gran escala ayudarán a garantizar que podamos continuar brindando un servicio seguro y confiable empleando energía libre de carbono.
La participación en programas para clientes residenciales y comerciales nos ayudará a cerrar la brecha para cumplir con nuestro objetivo y ayudar a mejorar la calidad del aire en nuestra región. La adopción del programa depende de una variedad de factores. Las cifras de participación pueden variar de un trimestre a otro dependiendo de estos factores.
Calculamos una vivienda equivalente totalmente eléctrica combinando proyectos de electrificación como una bomba de calor HVAC en una casa, un calentador de agua con bomba de calor de otra casa y una estufa de inducción de otra casa. Sumados, forman un hogar equivalente totalmente eléctrico. También incluimos el 100% de viviendas unifamiliares y multifamiliares totalmente eléctricas.
|
|
| 2025 final |
P1 2026 |
P2 2026 |
P3 2026 |
P4 2026 |
2026 Gol |
|
| Conversión de HVAC con bomba de calor | 3,797 | 738 | --- | --- | --- | 4,870 |
| Conversiones de calentadores de agua con bomba de calor | 789 | 300 | --- | --- | --- | 914 |
| Gas-to-electric induction cooktop conversions | N/A | 64 | --- | --- | --- | 410 |
| Electric-to-electric induction cooktop conversions | N/A | 33 | --- | --- | --- | 200 |
| Construcción de nuevas viviendas y unidades multifamiliares totalmente eléctricas | 2,208 | 45 | --- | --- | --- | 1,179 |
| Unidades multifamiliares reacondicionadas | 384 | 0 | --- | --- | --- | 249 |

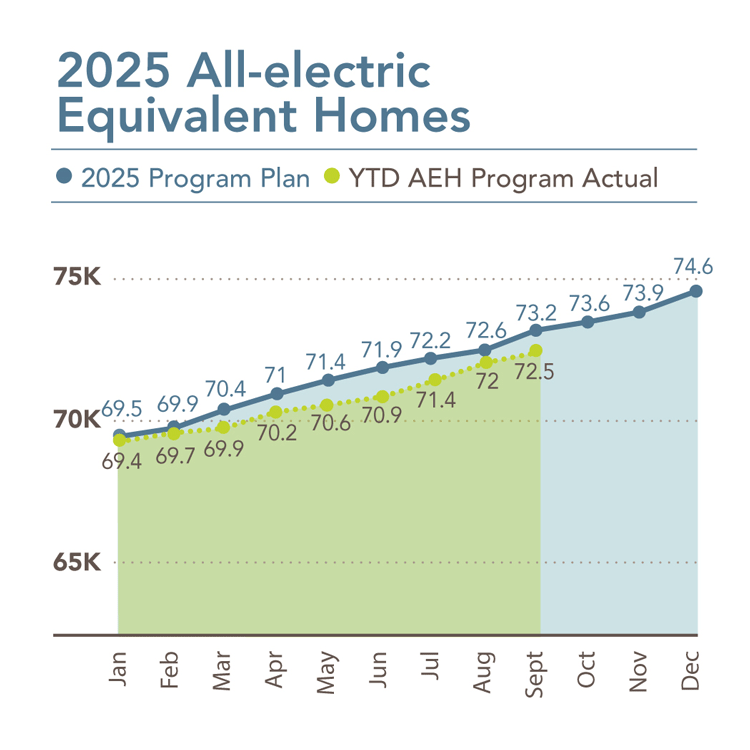

| Viviendas totalmente eléctricas equivalentes (acumulativas) | 73,617 | 74,666 | --- | --- | --- | 79,045 |
| |
|
| 2025 final |
P1 2026 |
P2 2026 |
P3 2026 |
P4 2026 |
2026 Gol |
|
| My Energy Optimizer® Socio (termostatos inteligentes acumulativos inscritos) | 38,080 | 39,326 | --- | --- | --- | 42,000 |
| My Energy Optimizer Socio (incluido en MW) | 29.7 | 30.7 | --- | --- | --- | 33 |
| My Energy Optimizer Socio+ (baterías Tesla) | 1,568 | 2,252 | --- | --- | --- | 1,870 |
| My Energy Optimizer Socio+ (Tesla MW inscrito) |
8.46 | 12.2 | --- | --- | --- | 10.1 |
| My Energy Optimizer Socio+ (baterías que no son de Tesla) |
88 | 130 | --- | --- | --- | 130 |
| My Energy Optimizer Socio+ (Incorporado a MW no Tesla) |
0.29 | 0.5 | --- | --- | --- | 0.5 |
| My Energy Optimizer Starter/TOD Optimized (baterías optimizadas para TOD) | 387 | 1,479 | --- | --- | --- | 6,687 |
| My Energy Optimizer Starter/TOD Optimized (MW optimizado) | 6.93 | 7.4 | --- | --- | --- | 16.7 |
| Peak Conserve o NextGen ACLM (dispositivos del cliente inscritos) |
1,749 | 1,304 | --- | --- | --- | --- |
| Peak Conserve o NextGen ACLM (incluido en MW) | 1.38 | 1 | --- | --- | --- | --- |
| PowerDirect Comercial (Clientes inscritos) | 41 | 36 | --- | --- | --- | 36 |
| Potencia comercial directa (MW inscritos) | 28.5 | 21.9 | --- | --- | --- | 21.9 |
| Carga gestionada residencial (cliente inscrito) |
N/A | -- | -- | -- | -- | --- |
| Capacidad total (MW)* | 77.56 | 76 | --- | --- | --- | 84.5 |
* El MW total incluye todos los programas de flexibilidad de carga, incluido StorageShares
|
|
| 2025 final |
P1 2026 |
P2 2026 |
P3 2026 |
P4 2026 |
2026 Gol |
|
| Cargadores residenciales de vehículos eléctricos instalados (reembolsos emitidos) | 2,556 | 273 | --- | --- | --- | 1,465 |
| Cargadores comerciales de vehículos eléctricos instalados (reembolsos emitidos) | 621 | 36 | --- | --- | --- | 661 |
| Participantes de la tarifa de vehículos eléctricos residenciales (acumulativa) | 36,028 | 37,000 | --- | --- | --- | 44,609 |
| Proyectos de E-Fuel Solutions | 4 | --- | --- | --- | --- | 3 |
| Número de vehículos eléctricos ligeros en territorio de servicio (acumulativo) | 76,385 | 78,254 | --- | --- | --- | 94,000 |
Para ayudarnos a lograr nuestro objetivo de energía libre de carbono para 2030, estamos trabajando en una variedad de proyectos a escala de servicios públicos para aumentar nuestra cartera de energía libre de carbono y mejorar la confiabilidad. A continuación se muestran los proyectos en los que estamos trabajando actualmente o que completamos.
| Estado | Nombre del proyecto | Capacidad agregada | Fuente de energía | Descripción |
|---|---|---|---|---|
| En curso | Acres de campo | 344 MW/ 172 MW |
Solar/Storage (Local – Placer County, CA) |
SMUD Board approved the Final EIR on April 20, 2023. Placer Planning Commission and Placer Conservation Authority Approved the Project and Mitigation Agreement on January 11 & 17, 2024, respectively. The Board of Supervisor approved the project on February 20, 2024. This is a SMUD developed project with a 3rd party power purchase agreement. Construction is underway and the project is scheduled to be online in 2027. Annual generation is estimated to be 637,000 MWhs and greenhouse gas reduction is estimated to be approximately 248,000 metric tons. |
| Cancelada | Arroyo Coyote | 200 MW/ 100 MW |
Solar/Storage (Local – Sacramento County, CA) |
On January 5, 2026, SMUD announced it was cancelling the power purchase agreement with DE Shaw for the procurement of energy for the Coyote Creek project due to project uncertainties including supply chain constraints, rising prices, tariffs, schedule delays, environmental impacts and pending litigation. |
| Under Evaluation | Curry Creek (Formerly Country Acres II) | 156 MW/ 156 MW-4hora | Solar/Storage (Local – Placer County, CA) |
SMUD is the lead agency for developing this project. Permitting activities are in progress. The project timeline and contracting model are under evaluation. Annual generation is estimated to be 442,000 MWhs and greenhouse gas reduction is estimated to be approximately 172,000 metric tons. |
| En curso | Gracia | 70 MW | Solar (Regional – Riverside County, CA) |
A 3rd party power purchase agreement for a 20-year term beginning December 2027 for 70 MW of renewable solar photovoltaic power from the Grace Orchard Energy Center Solar Project in Riverside County, CA. Annual generation is estimated to be 147,000 MWhs and greenhouse gas reduction is estimated to be approximately 57,000 metric tons. |
| Completo (2025) | Cresta del hacha | 101.2 MW | Wind (Regional – Shasta County, CA) |
A 3rd party power purchase agreement for a 7-year term beginning December 2025 for 101.2 MW of renewable wind power from the Hatchet Ridge Wind Project in Shasta County, CA. Annual generation is estimated to be 275,000 MWhs and greenhouse gas reduction is estimated to be approximately 107,000 metric tons. |
| Under Evaluation | Rancho Oveja | 75 MW / 37 MW- 4hr | Solar/Storage (Local – Sacramento County, CA) |
SMUD is the lead agency for developing this project. Permitting is complete. CEQA draft EIR was released in March and public meeting was held early April 2025. The FEIR was approved by the SMUD Board on 9/18/25. Sacramento County Board of Supervisors approved the Williamson Act contract amendment on 9/4/25. 30% design is complete. The project timeline and contracting model are under evaluation. Annual generation is estimated to be 190,000 MWhs and greenhouse gas reduction is estimated to be approximately 74,000 metric tons. |
| Completo (2025) | Casa de ciénaga | 50 MW | Solar (Local – Sacramento County, CA) |
SMUD is in contract with DE Shaw for the procurement of energy for the Sloughhouse project. The scope of the project is a 50 MW solar installation. Construction was completed in 2025 and the plant is operational. Annual generation is estimated to be 138,000 MWhs and greenhouse gas reduction is estimated to be approximately 54,000 metric tons. |
| Under Evaluation | Solano 5 (Repotenciación de Solano 2 ) | 94.5 MW | Wind (Regional – Solano County, CA) |
SMUD is the lead agency for developing this project. Permitting activities are in progress. The project timeline and contracting model are under evaluation. The project scope includes decommissioning Solano 2 by removing 29 old wind turbines and installing 21 new turbines. Planning and preliminary engineering underway. Annual generation is estimated to be 327,000 MWhs (an 80% increase in energy production) and greenhouse gas reduction is estimated to be approximately 128,000 metric tons. |
| En curso | Sunzia | 150 MW | Wind (Regional – New Mexico) |
A 3rd party power purchase agreement for a 15-year term beginning April 2026 for 150 MW of renewable wind power at the SunZia Wind Project in New Mexico. The developer holds firm transmission rights to deliver to the California Independent System Operator (CAISO) intertie where SMUD takes delivery. Annual generation is estimated to be 488,000 MWhs and greenhouse gas reduction is estimated to be approximately 190,000 metric tons. |
| En curso | Terra-Gen | 46 MW | Solar (Regional – Kern County, CA) |
A 3rd party power purchase agreement for an 8-year term beginning January 2027 for 46 MW of renewable solar photovoltaic power from the Sanborn 2 PV I LLC Project (S2PVI Project) in Kern County, CA. Annual generation is estimated to be 125,000 MWhs and greenhouse gas reduction is estimated to be approximately 49,000 metric tons. |
| Completo (2024) | Solano 4 | 85.5 MW | Wind (Regional – Solano County, CA) |
The project scope included decommissioning Solano 1 by removing 23 wind turbines in April 2023. The project scope also included the installation of 21 wind turbines (9 in Solano 4 East and 10 in Solano 4 West). Construction on the new turbines started in April 2023 and completed in May 2024. Annual generation is estimated to be approximately 232,000 MWhs and greenhouse gas reduction is estimated to be approximately 90,000 metric tons. With the completion of the Solano 4 project, SMUD Solano Assets (Solano 2, 3 & 4) have a total installed capacity of 300 MW. |
| Completo (2023) | Seto | 4 MW | Battery Storage (Local – Sacramento County, CA) |
La operación comercial del sistema de almacenamiento de energía de batería de iones de litio Hedge comenzó en enero 2023. El sistema proporcionará 4 MW de electricidad y 8 MW-hora de almacenamiento que se pueden aprovechar cuando otros recursos energéticos estén limitados, suficiente para abastecer 800 hogares durante 2 horas con energía limpia y renovable. |
| Complete (2023 & 2026) | Calpine | 100 to 150 MW | Geothermal (Regional – Lake County, CA) |
January 2023 marked the beginning of the 10-year PPA of energy from Calpine’s operations at The Geysers, which added 100 MWs of geothermal energy to SMUD’s portfolio. In January 2026 the contract was expanded by 50 MW for a total of 150 MW and extended through 2042. The Geysers is the single largest geothermal electric operation in the world. Annual generation is estimated to be 1,314,000 MWhs and greenhouse gas reduction is estimated to be approximately 504,000 metric tons. |
| Completo (2022) | Drew Solar | 100 MW | Solar (Regional – Imperial County, CA) |
The Drew Solar Project, completed in 2022, is a 30-year Power Purchase Agreement (PPA) for 100 MW Solar located in Imperial County. Annual generation is estimated to be 282,000 MWhs and greenhouse gas reduction is estimated to be approximately 121,000 metric tons. |
¿Desea obtener más información sobre cuánta energía están usando nuestros clientes y de dónde proviene la energía?
Ver el consumo de energía actual y esperado
Información del año anterior
Puede encontrar información de años anteriores en las páginas siguientes:
- 2025 página de emisiones y programas
- 2024 página de emisiones y programas
- 2023 página de emisiones y programas
